Contract Clauses Every Kolkata Homeowner Should Ask For Before Hiring a Designer

Contract Clauses Every Kolkata Homeowner Should Ask For Before Hiring a Designer
We get a version of the same phone call every few months, right, a homeowner somewhere between AC Block in Salt Lake and Action Area 1 in New Town who signed on with a designer six or seven months ago on the strength of a good mood board and a warmer than expected first meeting, and who is now sitting on a half finished apartment with no completion date in writing, no clarity on who pays for the cracked tile the plumber's crew broke, and a WhatsApp thread that has gone quiet for eleven days. The apartment usually isn't the real problem. The contract is, or more precisely, the absence of one that actually says anything, and that gap between "we'll sort it out" and a clause that spells out what happens when things go wrong is where most Kolkata interior projects quietly go sideways.
We've been doing this since 2014, we've delivered over 330 buildings across Kolkata, New Town and Salt Lake in that stretch, and if there's one thing that separates a project that finishes on schedule for a fair price from one that drags into its fourteenth month with a homeowner calling three different subcontractors trying to figure out who's responsible for a leaking bathroom, it's what got written down before anyone touched a wall. This isn't a legal lecture, we're not lawyers and won't pretend to be, but we've sat across the table from enough homeowners who got burned by vague paperwork to know exactly which clauses matter and why, and we think you should ask for every one of them before you sign with anyone, us included.
Why a mood board is not a contract
Most first meetings with a designer in Kolkata go the same way, a portfolio gets shown, a rough budget gets discussed, everyone gets along, and a request for the first installment shows up within the week. The catch here is that liking your designer tells you nothing about what happens in month four, when the modular kitchen vendor delivers the wrong shutter finish, or when the false ceiling contractor wants three more days that quietly turn into three more weeks. A written scope, signed by both sides, with specific clauses covering money, materials, timelines and liability, is the only thing that actually protects you once the relationship stops being a first date and starts being a construction site. Basic due diligence before you sign anything, checking who you're actually contracting with, whether it's a registered firm or an individual freelancer working out of a laptop, matters more than most homeowners realize until it's too late to matter.
| Handshake deal | Written contract |
|---|---|
| No fixed payment stages, money asked for "as needed" | Payment tied to named milestones, each one signed off before the next installment |
| Verbal promise of an 8-12 week timeline | Written completion date with a stated delay penalty |
| "We'll use good quality material" as a phrase | Exact brand, model number and quantity for tiles, fittings and hardware |
| Unclear who pays for site damage or defects | Named defect liability period with a clear responsible party |
The payment schedule clause, tied to milestones and not the calendar
The single most common trap we see in Kolkata is a payment schedule structured around dates rather than deliverables, so the homeowner is contractually obligated to pay the third installment on the first of the month regardless of whether the civil work has actually reached that stage. A payment clause worth signing ties every installment to a physical milestone, foundation and civil work complete, electrical and plumbing rough-in done, false ceiling and paint complete, final handover after snag list clearance, so you're never paying 60% of the contract value for 30% of the work. For a mid-sized 3BHK renovation in Salt Lake or New Town, this usually breaks into four to six stages rather than two or three, and any designer unwilling to structure it that way is telling you something about how confident they are in their own timeline.
| Stage | What It Covers | Typical Trigger | |||
|---|---|---|---|---|---|
| Booking | Design finalization and material selection | Signing of contract | |||
| Stage 1 | Civil work and structural changes | Site handover and demolition complete | |||
| Stage 2 | Electrical | plumbing | carpentry base work | Rough-in inspection passed | |
| Stage 3 | Finishing | false ceiling | paint | modular units | Installation substantially complete |
| Final | Snagging | polish | handover | Client walkthrough and sign-off |
The scope of work and material specification clause
"Good quality" is not a specification, it's a marketing phrase, and a contract that describes materials that way is a contract designed to be argued about later. What you want in writing is the actual brand, the model or SKU where applicable, the quantity, and the finish, for every major line item, tiles, sanitaryware, modular kitchen shutters, wardrobe hardware, lighting fixtures, and paint. This is exactly where projects involving modular kitchen design or a full residential interior design scope tend to fall apart, because a vague "premium laminate" line item can mean three very different price points depending on who's reading it and when. We build our own scope documents down to catalogue numbers precisely because we've watched what happens on other people's sites when that line is left fuzzy, the homeowner discovers a substitution at handover and by then there's no leverage left to fix it.

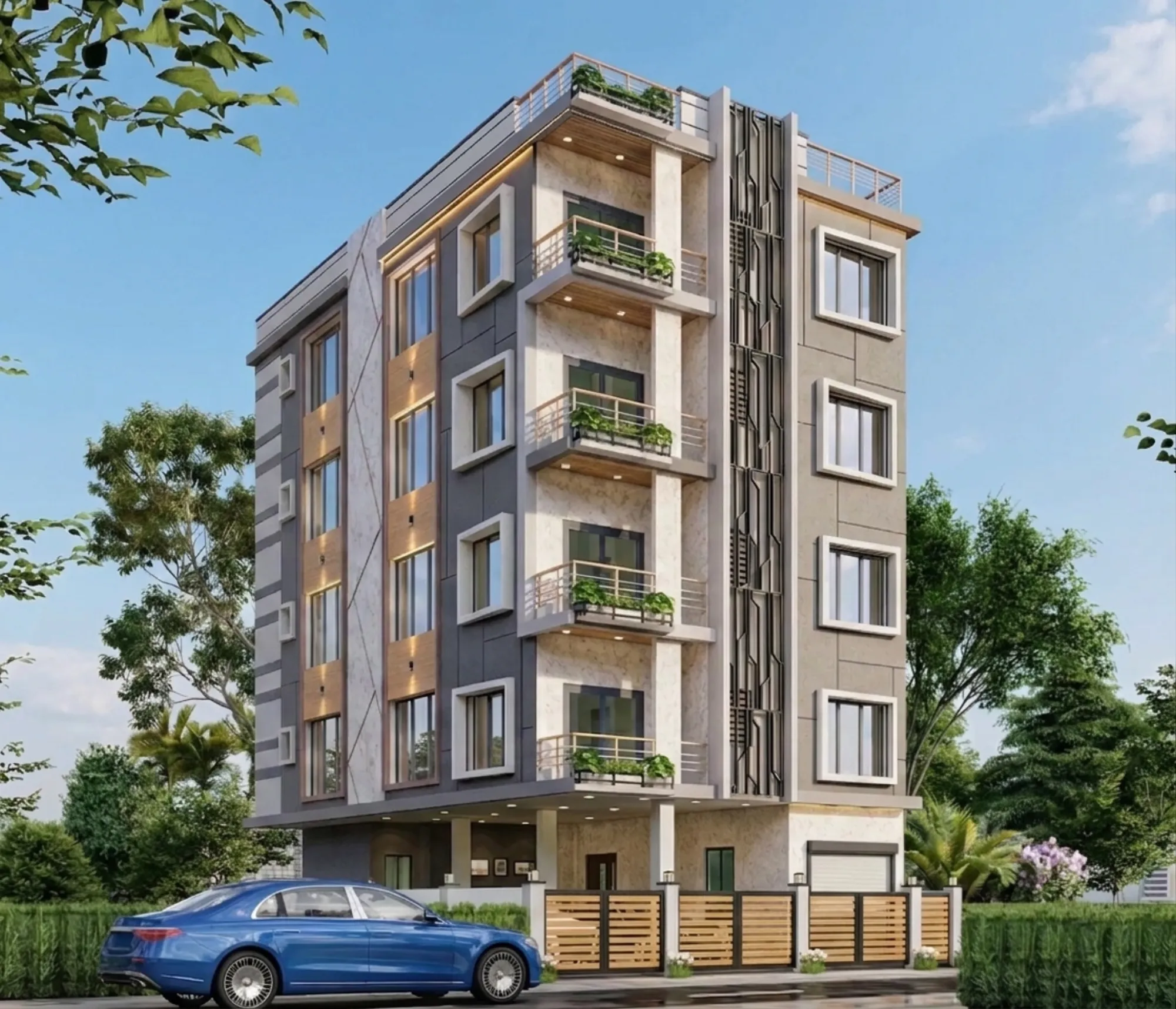

That's the DE Block residence in New Town, one of the projects where the material schedule was locked to exact specifications before a single tile order went out, which is a big part of why the finish matched what was promised at the design stage rather than what happened to be available at the local vendor that month. If you want a sense of how that kind of specificity plays out on a real build, our DE Block residence project is worth a look, and it's the kind of documentation discipline we'd recommend asking any firm you're evaluating, not just us, to demonstrate before you sign.
The timeline clause, and what actually happens when it slips
Every designer will quote you a timeline in the first meeting, and almost every homeowner in Kolkata has heard "8 to 10 weeks" only to still be waiting at week twenty two. The clause that matters here isn't the timeline itself, it's what's written for when the timeline isn't met, specifically whether there's a defined delay penalty, whether force majeure carve outs are reasonable rather than broad enough to excuse anything, and whether the client's own delays, like slow material approvals, are separated from the contractor's delays in how the clock gets counted. We quote 8 to 12 weeks as our typical turnaround for a standard residential interior project, and we write that range, along with what happens if we blow past it, directly into the contract rather than leaving it as something said once in a meeting and never referenced again.
Change orders and how "extra work" actually gets priced
Almost every renovation in Kolkata picks up scope creep somewhere, a client decides mid-project to add a false ceiling with cove lighting, or the site reveals a structural issue that needs an unplanned fix. That's normal, and it's not the problem. The problem is a contract silent on how those additions get priced and approved, which leaves the homeowner discovering a padded final bill with line items nobody agreed to in writing. A proper change order clause requires written client sign off before any additional work begins, states how the incremental cost will be calculated, whether it's a percentage markup over material cost or a fixed day rate for the general contractor coordinating the crew, and folds any timeline extension into the same document. If you're weighing a full renovation against smaller phased work, our guide on turnkey home interiors in New Town walks through how scope decisions early on affect exactly this kind of mid-project cost creep later.
Defect liability, warranty, and who actually shows up after handover
Handover day feels like the finish line, but it's usually where the real test starts, because that's when you find out whether the paint holds up through the first monsoon, whether the modular kitchen hinges are still tight after three months of daily use, and whether anyone answers the phone if something needs fixing. A defect liability clause with a defined period, commonly six months to a year depending on scope, names who is responsible for post handover fixes and at what cost, and it should be distinct from the standard product warranty that comes from the manufacturer of, say, the sanitaryware or the modular hardware. Homeowners who skip this clause often end up in a position where the designer has moved on to the next project and getting a callback for a sagging cabinet door becomes a multi week negotiation. It's also worth understanding how this interacts with your broader legal protections under the RERA Act, 2016, even though most interior fit out work sits outside strict RERA coverage, because the spirit of that framework, defined timelines and defined liability, is exactly what a good private contract should replicate for you.
- Milestone-based payment schedule, not calendar dates
- Named brand, model and quantity for every major material
- Written timeline with a stated delay penalty
- Change order process requiring signed approval before extra billing
- Defect liability period clearly separate from manufacturer warranty
What we actually put in our contracts, and why local knowledge matters here
None of this is theoretical for us, because we've built across enough of New Town and Salt Lake, and neighbourhoods further into central and south Kolkata including areas like Alipore, to know exactly where projects tend to break down when the paperwork is loose. We've spent over a decade working through NKDA sanction requirements for structural changes in New Town, Bidhannagar's municipal process for Salt Lake cooperative flats, and KMC norms further into the city, and that regulatory familiarity shapes the contracts we write, because we know which approvals need to be sequenced before which construction stage, and we build those dependencies into the payment schedule itself rather than discovering them mid project. If you're trying to work out realistic budgeting before you even get to the contract stage, our guide on the cost to build a house in New Town is a useful starting point, and our breakdown of interior designers in New Town covers how local firms typically structure their fee models.
We've also seen the flip side up close, homeowners who read our red flags checklist for hiring an interior designer in New Town after a bad experience elsewhere, and the pattern is almost always the same, a designer who was easy to talk to but hard to pin down on paper. Our questions to ask an interior designer before hiring in New Town guide covers the conversation side of this, and honestly, at the end of the day, the questions and the contract clauses are the same exercise, you're just deciding whether to ask them out loud or get them in writing. We'd strongly suggest doing both, and if the firm you're talking to gets defensive about writing any of this down, that itself is the most useful information you'll get in the entire evaluation.
An architect or interior firm that's confident in its own project management process shouldn't hesitate to put milestones, material specs, delay penalties and defect liability into a signed document, and if you're evaluating firms for a fuller architectural scope alongside interiors, our residential architecture work follows the exact same contract discipline from the sanction stage through to handover. You can browse the range of what that discipline has actually produced across our full project portfolio, 330-plus buildings and counting since 2014, each one built on a contract that named its stages, its materials and its liabilities before the first wall came down. If you're at the stage of comparing designers for a New Town, Salt Lake or Kolkata home and want a contract that actually protects you rather than one that just gets you to sign, get in touch with us and we'll walk you through exactly what we'd put in writing for your specific project.
